CSLB C-42

Sanitation System Contractor License Exam Prep (C-42)

Getting ready for the California sanitation system contractor license exam (CSLB C-42)? Study with 184 practice questions in 2 categories and 6 Learning Hub lessons, made for septic and sewer contractors, with the Law and Business exam included.

One-time purchase, no subscription. Law & Business included.

Diagrams from the C-42 sanitation system contractor lessons: Sizing a Septic Tank: Bedrooms, Flow, and Compartments, Sizing a Leach Field: Soil, Square Feet, and Trench Length, Sizing a Seepage Pit: Sidewall Area and Block Count and Setback Distances: Reading Table H 101.8
184practice questions
2categories
6Learning Hub lessons
$249Law & Business included

What the exam covers: Sanitation System (C-42)

The CSLB exam for the California sanitation system contractor license (C-42) is a closed-book, multiple-choice test. CSLB's official study guide divides it into five major sections and gives each an approximate weight: Planning and Estimating (about 27%), New Septic System Installation (about 26%), Sewer Lateral Installation and Repair (about 10%), Septic System Maintenance and Repair (about 10%), and Safety (about 27%).

Planning and Estimating carries the most weight, about 27%, so it deserves roughly that share of your study time, with Safety next at about 27%.

Contractors Classroom turns that outline into 184 practice questions in 2 categories (Planning and Estimating and Cal-OSHA Biohazard, Trenching & Confined Space Safety), plus 6 Learning Hub lessons with diagrams (such as "Sizing a Septic Tank: Bedrooms, Flow, and Compartments" and "Sizing a Leach Field: Soil, Square Feet, and Trench Length"). Law and Business, which most applicants take alongside their trade exam, is included at no extra charge.

Exam sections and approximate weights

  • Planning and Estimating~27%
  • New Septic System Installation~26%
  • Sewer Lateral Installation and Repair~10%
  • Septic System Maintenance and Repair~10%
  • Safety~27%

Practice question categories

  • Planning and Estimating75 practice questions
  • Cal-OSHA Biohazard, Trenching & Confined Space Safety109 practice questions

What the Sanitation System Contractor exam covers, section by section

Planning and Estimating (~27%)

Good septic work begins with understanding the property: soil conditions, water use, available space and the loads the system will serve. Planning translates those findings into a layout and a sequence that fits the lot and the permit process. Estimating then adds up excavation, tanks, piping, drain field materials, equipment time and labor, giving a price that covers the real conditions rather than a guess. Percolation behavior, the depth to groundwater and the number of fixtures feeding the system all shape tank size and field length.

  • Weighing soil, groundwater, lot space and expected flow to lay out a workable system
  • Pricing excavation, tanks, pipe, drain field materials, machinery and labor into a complete bid

New Septic System Installation (~26%)

A new system is built in stages, starting with setting the tank on a prepared base and connecting it so wastewater flows by gravity and settles properly. From there, effluent is spread through leachlines or seepage pits sized for the soil. Before backfilling, the work is checked for leaks and grade, and alternative or specialty units are added where site conditions call for something beyond a conventional layout. Tank risers are brought to grade so lids are reachable for pumping, and distribution boxes are leveled so flow splits evenly among the lines. Heavy equipment must stay off the finished field to avoid compacting the soil.

  • Placing tanks level on firm bedding with sealed inlets, outlets and accessible access risers
  • Excavating trenches or pits and laying distribution lines so effluent soaks evenly into soil
  • Checking watertightness and finished grades before covering, then shaping the ground above the system
  • Setting up aerobic or other advanced treatment units where soil or space rules out conventional layouts
  • Handling unusual systems such as holding tanks, pumps or special-use installations

Sewer Lateral Installation and Repair (~10%)

A sewer lateral carries wastewater from a building to the main or to a treatment system, so its slope, joints and bedding determine whether it flows freely for years. Installation involves trenching, laying pipe to consistent fall and connecting at both ends. Maintenance and repair of existing lines includes locating blockages, cracks or root intrusion, then clearing, patching or replacing sections with as little disruption as possible. Cleanouts at accessible points allow future cameras and augers to reach the line. Cast iron, ABS or PVC each calls for its own joining method, and poor connections are a common source of root entry.

  • Trenching, bedding and joining pipe at steady fall, then connecting to the building and main
  • Locating blockages, root damage or broken pipe and clearing, relining or replacing the affected run

Septic System Maintenance and Repair (~10%)

Older systems announce trouble through slow drains, odors, soggy ground or backups, and the job is to work out which component is responsible. Repair may mean replacing a failed baffle, pump or section of drain field, while some systems are better removed and properly abandoned. Routine pumping, inspection and record keeping extend the life of whatever remains in service. A rising effluent level in the tank, a failed outlet filter or a pump that cycles constantly often points to the cause. Disturbed sludge and scum layers must be handled carefully when a tank is opened.

  • Reading symptoms like backups, odors and wet ground to pinpoint which component has failed
  • Repairing damaged parts or decommissioning obsolete tanks and pits so they are safely filled
  • Pumping, inspecting and recording service on tanks and fields to keep them performing

Safety (~27%)

Septic work combines deep excavations, heavy machinery and exposure to sewage gases and pathogens, so safety is built into every step. Employees need instruction in hazards, hygiene and the correct response to emergencies before they enter a trench or a tank. On site, crews shore or slope excavation walls, keep equipment traffic controlled, test the air in confined spaces and keep the public away from open work areas. Tank lids can be heavy and corroded, so they are lifted with proper tools and replaced securely to prevent anyone falling in.

  • Teaching workers about sewage hazards, hygiene, confined space entry and emergency response
  • Shoring trenches, controlling machinery movement and fencing off open excavations from the public

Code books behind the Sanitation System Contractor exam

The exam outline published for this trade lists these references.

  • 2025 California Plumbing CodeThis code carries the rules that decide a C-42 job: septic tank sizing by bedrooms or flow, disposal field and seepage pit sizing from soil, setbacks from wells and property lines, building sewer slope, size and cleanouts, and private sewage disposal appendix requirements. It feeds Planning and Estimating, New Septic System Installation and Sewer Lateral Installation and Repair. Keep its tables for tank sizes, soil absorption values and setbacks at the front of your study, because several exam sections draw on them.
  • A Builder’s Guide to Wells and Septic SystemsA builder-oriented book on how wells and onsite wastewater systems are sited, designed and installed together. It explains soil testing, tank and field layout, and separation between water supply and wastewater, which supports planning decisions and the installation steps for tanks, fields and pits. It is also a good place to understand why water wells and septic systems are separated.
  • Pipe & Excavation ContractingA contractor guide to trench layout, pipe laying, bedding, backfill and the costs of underground utility work. For sanitation contractors it links excavation and piping practice to sewer laterals and septic installations, and it supports the estimating bullets of the planning section. Its production and equipment notes help with the cost questions about trucks, backhoes and labor.
  • Residential Onsite Wastewater Treatment Systems: An Operation and Maintenance Service Provider ProgramA training program for people who inspect, service and maintain onsite systems: how tanks, filters, pumps, fields and alternative treatment units behave, how failures show up, and what routine service involves. It is the study source for troubleshooting and maintaining existing septic systems and for alternative treatment systems. Reading it shows how a service provider thinks about a failing system, which is the point of view many repair questions take.
  • State of California General Industry & Electrical Safety Orders (Cal/OSHA)The Title 8 safety orders cover trenching and excavation, entry into tanks and other enclosed spaces with atmosphere testing and rescue provisions, biological hazards, hazard communication and electrical safety. They are the reference for the Safety section, which equals the largest sections of the exam in weight. Study the atmosphere limits and the roles of entrant, attendant and supervisor as a connected set.

Key terms for the Sanitation System Contractor exam

Effluent filter
A cartridge at the outlet of a septic tank that catches solids before they travel to the disposal field. It protects the field from clogging, but it needs periodic cleaning, and a blocked one is a typical cause of slow drains.
Septage
The material pumped from a septic tank: floating scum, liquid and settled sludge. It is hauled and disposed of under public health rules, and the trucks that move it are regulated separately from ordinary delivery vehicles.
Sludge and scum layers
Inside a working tank, heavy solids settle into sludge while grease and light solids float as scum, leaving a clearer zone between them. Pumping is due when these layers take up too much of the tank's depth.
Percolation test
A field test in which holes are dug at the proposed absorption area, soaked, and then watched for how quickly the water level drops. The rate of fall rates the soil and is used to size fields and seepage pits.
Disposal field
A set of perforated pipes laid in gravel-filled trenches that spreads clarified effluent into the soil. Its length depends on soil absorption, and the code limits trench width, line length, cover and spacing between lines.
Distribution box
A box that receives flow from the tank and divides it among the lines of a field. It must be level so each line gets its share, otherwise one line overloads and the field fails early.
Seepage pit
A deep, lined excavation, usually circular, where effluent soaks out through the walls into surrounding soil. It is used where soils below the surface absorb well, and larger or more numerous pits are needed in tight soil like clay.
Sidewall absorption area
The wall surface of a pit below the inlet that can actually take in liquid, excluding any hardpan, rock or clay layer. Required area divided by the circumference tells how deep a pit must be.
Reserve area
Land set aside, and kept clear of buildings and driveways, for a future replacement field or pit of at least the original size. It lets the owner rebuild the system if the first one fails.
Biomat
A dark, slimy layer of microbes and organic matter that forms where effluent meets soil. A thin one helps treatment, but a thick one slows absorption, which is why overloaded systems and heavy grease can lead to surfacing wastewater.
Setback distance
The minimum separation the code requires between parts of a sewage system and things such as wells, buildings, streams, property lines and water lines. The distance differs by component, and footnotes can change it.
Hardpan
A dense, cemented soil layer that water barely penetrates. It is excluded when absorption area is counted, and finding it during a pit or trench excavation can change the whole design.
Aerobic treatment unit
A package plant that bubbles air through wastewater so oxygen-loving bacteria treat it more thoroughly than a plain tank. It is one kind of alternative treatment system, and it needs power, alarms and regular service.
Building sewer fall
The downward slope of the pipe carrying waste from the building to the disposal point. A uniform slope keeps solids moving with the liquid, while too little slope leaves solids behind and too much leaves the water running ahead of them.
Vacuum truck
A tank truck with a pump that sucks septage and other liquid waste from tanks and sewers. The public health department regulates these trucks and their loads, so questions about who authorizes them are fair game.
Hydrogen sulfide
A toxic gas given off by decomposing waste, recognized by a rotten-egg smell. At higher levels it dulls the sense of smell, so odor cannot serve as a warning, and it collects in tanks and sewers.
Lower flammable limit
The smallest concentration of a gas or vapor in air that can burn. Tank entry rules treat readings above a small fraction of this limit as a hazardous atmosphere, such as methane building up in a septic tank.
Entry attendant
The person who stays outside a tank or sewer for the whole entry, keeps track of those inside and calls for rescue. The attendant does not go in, even to help, because a second victim doubles the emergency.
Atmospheric testing
Checking the air in a tank with a calibrated meter before and during entry, taking oxygen first, then flammable gases, then toxic gases. The order matters because many combustible gas meters need oxygen to read correctly.

Where to spend practice time for the Sanitation System Contractor exam

  • Sizing tanks, fields and pitsPlanning and Estimating is about 27 percent of the exam and shares the top spot with Safety. Practice sizing a tank from bedrooms or daily flow, a field from soil absorption and a pit from sidewall area, then turning area into trench length or block counts. Repeat with different soils, since clay changes every answer. Check results against the minimum field size the code sets.
  • Safety in tanks and trenchesSafety is about 27 percent of the exam, with training and job site rules. Rehearse the logic of entering a tank: identify hazards, test the air in the right order, station an attendant, plan rescue, and dig the surrounding hole safely. Add biohazard handling for sewage, since the practice set mixes all three topics.
  • Installing septic systemsNew Septic System Installation is about 26 percent of the exam and covers tanks, leachlines, seepage pits, grading over the system, alternative treatment and specialty systems. Sketch an installation in order from excavation to cover, noting compartments, baffles, slopes and depth limits, and study what makes alternative systems different. Know what a compartment ratio and an access riser are for.
  • Setbacks and reserve areasSetback tables underlie planning, installation and repair questions, and the footnotes often change the answer. Practice reading the table by component column, recalling the distances between tanks, fields and pits themselves, and applying the rule that the system stays on its own lot with room kept for a replacement area. Drawing a lot plan with every distance labeled works well.
  • Sewer lateralsSewer Lateral Installation and Repair is about 10 percent of the exam. Review slope rules, how fixture units set the pipe size, how wide to cut the trench for plastic pipe and what bedding it needs, cleanout placement, clearances from water lines and wells, and how an old lateral is tested or abandoned. Small points, but easy to confirm with practice. Practice converting fixture units to pipe size using the table.
  • Troubleshooting failing systemsSeptic System Maintenance and Repair is another 10 percent. Link symptoms such as gurgling, surfacing liquid, backups or lush grass over a field to causes like a blocked filter, a full tank, clogged lines or an overloaded soil. Also review pumping intervals, safe removal of an old tank and what repairs involve. Ask yourself what you would check first each time.

Scenarios to talk through before the Sanitation System Contractor exam

  • Planning a four-bedroom septic systemA client plans a four-bedroom home on a rural lot. Which route do you use to size the tank, how do compartments affect the layout, and what soil information must you gather before deciding on a field or a pit? Say what changes if the owner later adds a fifth bedroom. State which table the soil result feeds.
  • Slow percolation in clayA percolation test shows slow absorption in clay. Think about what happens to required sidewall area for a pit, whether more or deeper pits make sense, how hardpan changes the count, and how to connect several pits. Explain what you would tell the designer about the spacing. Say how the answer changes if the pits sit in coarse sand.
  • Checking the lot planA lot plan shows a tank, field, well and garage with a porch. Which separation distances do you check, how do footnotes change them, and how do you keep room for a replacement area so the property can be developed later? Say which dimensions you would measure from the porch and garage.
  • Setting the box and filterYou are installing the distribution box and outlet filter. How do you ensure each line gets an equal share, what does a tilted box do over time, and what instructions would you give about cleaning the filter? Say how you would verify the level with a tool before backfilling. Describe how you would label each outlet to the field.
  • Laying a sewer lateralA new building sewer runs from the house to the tank. How do you set fall, choose the size from fixture units, choose how wide to cut the trench and what bedding the plastic pipe needs, place cleanouts, and keep safe distances from water lines and wells? Add what test the new line receives before the trench closes.
  • Entering a tank for repairA baffle inside a buried tank needs repair. Describe the order of atmosphere tests, which gases worry you, what the attendant does, how rescue is arranged, and how the excavation around the tank is made safe. Say what you would do if the meter reads outside safe limits. Mention which gas would sit low and which would collect near the top.
  • Wet spot over the fieldAn owner reports wastewater surfacing above the field and slow drains in the house. Link possible causes such as a full tank, a clogged filter, a biomat or an overloaded soil to the checks you would make and the order you would make them. Describe what you would tell the owner to change at home.
  • Pumping and aerobic serviceA service call combines a pumping visit and an aerobic unit alarm. What agency rules cover the truck and septage, what do sludge and scum levels tell you, and which alarm, power and air-supply checks do you make on the unit? Mention what records the hauler and the service provider each keep.

Learning Hub lessons

Each lesson has guided steps, a diagram, a worked example and a quick check inside the classroom.

Preview the lesson diagrams

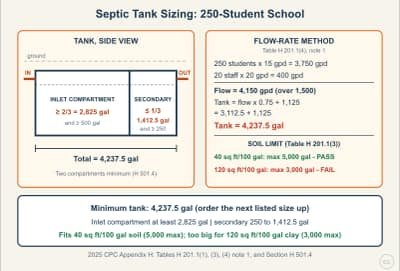

  1. Sizing a Septic Tank: Bedrooms, Flow, and CompartmentsSteps: Two Routes to the Tank Size; Dwellings: Table H 201.1(1); Everything Else: Flow Rate and the Two Formulas; Compartments Inside the Tank; Check the Tank Against the Soil

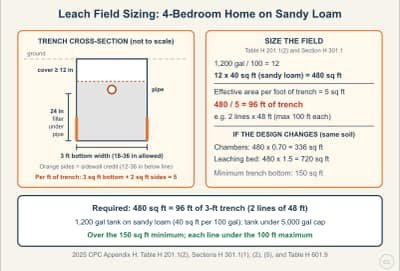

  2. Sizing a Leach Field: Soil, Square Feet, and Trench LengthSteps: Start With the Soil Type; Which Gallons Do You Use; Minimums, Credits, and Multipliers; Turn Square Feet Into Trench Length; Protect the Field and Its Reserve

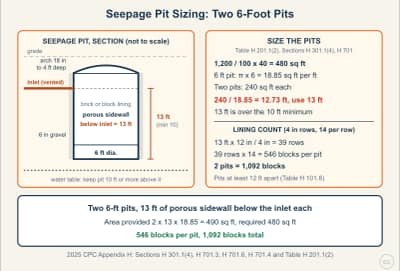

  3. Sizing a Seepage Pit: Sidewall Area and Block CountSteps: A Pit Absorbs Through Its Sidewall; Why Percolation Testing Matters; Pit Geometry Rules; Lining the Pit; Multiple Pits and Spacing

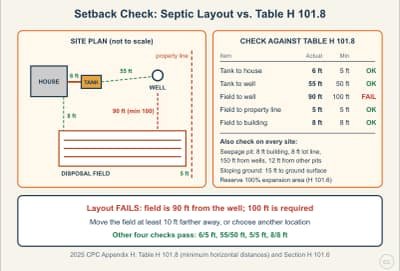

  4. Setback Distances: Reading Table H 101.8Steps: The Rule: Same Lot, Minimum Distances; Read the Table by Column; Component-to-Component and Water Lines; The Footnotes Change the Number; Protect the Reserve Area and Document It

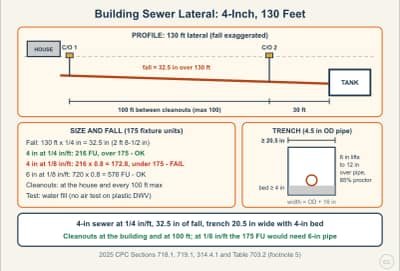

  5. Building Sewer Laterals: Fall, Size, Trench, and CleanoutsSteps: Fall: The Slope Rules for a Building Sewer; Size the Sewer by Fixture Units; Trench Width and Bedding for Plastic Sewer Pipe; Cleanouts on the Lateral; Distances, Testing, and Abandoned Lines

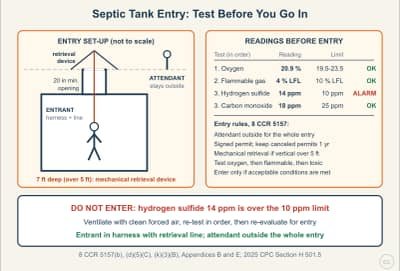

  6. Entering a Septic Tank or Sewer: Confined-Space Atmosphere RulesSteps: A Tank Is a Confined Space, Often a Permit Space; What Counts as a Hazardous Atmosphere; Test in the Right Order, With a Calibrated Meter; Attendant, Permit, and Rescue; The Excavation Around the Tank

See the classroom in action

Frequently asked questions

How do I get a California sanitation system contractor license?

A septic installer or sewer contractor who wants to contract independently applies under C-42. CSLB generally requires documented journey-level experience, a bond, and passing scores on both the Law and Business exam and the C-42 exam. Rules change, so confirm them with CSLB.

What does the sanitation system contractor exam ask about planning and estimating?

Planning and Estimating is the heaviest part of the C-42 exam, at about 27%. Expect questions on weighing soil, groundwater, lot space and expected flow to lay out a workable system and pricing excavation, tanks, pipe, drain field materials, machinery and labor into a complete bid. Next in weight come safety (about 27%) and new septic system installation (about 26%).

What kinds of questions are on the sanitation system contractor exam?

The three sample questions in CSLB's C-42 study guide ask about which agency permits vacuum trucks, how many blocks line a seepage pit, and how clay soil changes seepage pit design. Like every question on the exam, each has four choices and one best answer.

Which codes and books does the C-42 exam reference?

CSLB's C-42 study guide lists the 2025 California Plumbing Code (Title 24), the Cal/OSHA safety orders (Title 8), and trade references such as A Builder’s Guide to Wells and Septic Systems, Pipe & Excavation Contracting, and Residential Onsite Wastewater Treatment Systems. Use them to study; the exam itself is closed-book.

Is the sanitation system contractor exam open book?

No. The C-42 study guide says no reference materials may be used, even though it names A Builder’s Guide to Wells and Septic Systems and Pipe & Excavation Contracting among the books to study from. A calculator is provided, and guessing is not penalized.

Can I take the sanitation system contractor exam outside California?

CSLB's exam FAQ says trade exams are given in California or Oregon only, so C-42 is not offered in other states, although Law and Business can be taken out of state. Check the current PSI list when you schedule.

How are the 184 C-42 practice questions organized?

They are split into 2 categories, largest first: Cal-OSHA Biohazard, Trenching & Confined Space Safety (109) and Planning and Estimating (75). Cal-OSHA Biohazard, Trenching & Confined Space Safety holds about 59% of the questions. 6 Learning Hub lessons add diagrams and worked examples for the harder topics. The missed-question review collects every question you get wrong.

Is there a free trial for sanitation system contractor exam prep (C-42)?

Yes. The free C-42 preview opens the real classroom with no sign-up and gives you the first question from every C-42 category, including Cal-OSHA Biohazard, Trenching & Confined Space Safety and Planning and Estimating, plus Law and Business. The full course is a one-time $249 purchase.

Is sanitation system contractor exam prep available in Spanish?

The website and the eight demo videos are available in Spanish. The classroom and the 184 C-42 practice questions are in English for now; translating the questions is not part of the course yet.
